EV charging station installation cost varies widely by market. As a 2026 planning benchmark, a commercial AC port ranges from about $2,300 to $10,450, while a high-power DC port can reach $210,000 or more. Hardware is rarely the biggest line item. Site conditions, electrical infrastructure, permits, and local service capability decide most of the budget. This guide explains the cost structure by charger type and how to localize the estimate for your market.
We watched a hotel operator in Southeast Asia budget $8,000 per commercial AC port, only to discover mid-project that the site needed a full panel upgrade. Final cost: $14,500 per port. The hardware price never changed. The electrical infrastructure and site preparation costs did.
Key Takeaways
- Installed cost is dominated by infrastructure, not hardware: planning benchmarks put an AC port at $2,300 to $10,450 and a high-power DC port at up to $210,000+.
- China factory-direct hardware runs $300 to $450 for a 7–22 kW AC charger and $5,200 to $9,500 for a 20–360 kW DC fast charger. The 5 m cable is standard.
- The biggest budget risks are panel and service upgrades ($1,500 to $50,000+), trenching ($50 to $200 per linear foot), and utility timelines (up to 18 months).
- Landed cost includes regional freight, import duties, taxes, certification, permits, and local labor. Get these items priced locally before approving a project.
- Six or more ports at once, plus load management, cuts per-port installation costs by 30% to 50%. Cheap hardware that fails early wipes those savings out.

EV Charging Station Installation Cost by Charger Type
Commercial EV charging stations run on 7–22 kW AC chargers and 20–360 kW DC fast chargers. In 2026, China factory-direct hardware costs $300 to $450 for an AC unit and $5,200 to $9,500 for a DC fast charger. Installed costs are another story: roughly $2,300 per AC port up to $210,000+ per high-power DC port in mature commercial markets. Use the table as a cost-structure benchmark, then replace each line with a local quote.
| Charger Type | Hardware (China direct) | Installation benchmark | Total benchmark |
|---|---|---|---|
| AC Charger, Level 2 (7–22 kW) | $300–$450/unit | $2,000–$10,000/port | $2,300–$10,450/port |
| DC Fast Charger (20–150 kW) | $5,200–$9,500/unit | $40,000–$120,000/port | $45,000–$130,000/port |
| High-Power DCFC (150–360 kW) | $5,200–$9,500/unit | $50,000–$200,000+/port | $55,000–$210,000+/port |
Reading the table: hardware figures are China factory-direct, single-unit prices and assume the standard 5 m charging cable. Lower power ratings sit near the bottom of the DC range; 150–360 kW units sit near the top. Installation benchmarks cover electrical work, trenching, permits, and site preparation in mature commercial markets. They exclude regional freight, import duties, VAT and other local taxes. Installation dominates the total on most projects, but the exact mix differs by market.
Looking for a project-specific estimate? Use Klitv’s ROI Calculator to model your costs and payback period, or contact our team for a custom quote.
Level 1 Is Not Used in Charging Stations
Level 1 equipment plugs into a standard single-phase household outlet and delivers only 1.2 to 1.4 kW, or roughly 3 to 5 miles of range per hour. Outlet voltage varies by market. It’s essentially never specified for a commercial charging station: dwell times are far too long and revenue per port is too low. Station operators choose 7–22 kW AC chargers for workplace and destination parking, and 20–360 kW DC fast chargers where quick turnaround matters. Level 1 belongs to residential and portable use cases, not station deployments.
AC (Level 2) Charger Installation Cost: 7–22 kW
An AC Level 2 charger delivers 20 to 30 miles (32 to 48 km) of range per hour at 7, 11, or 22 kW. Supply voltage and phase configuration vary by market, so confirm the site’s grid standard and local electrical code before ordering. China factory-direct hardware costs $300 to $450 per unit, the lowest equipment price of any station-grade charger. As a mature-market benchmark, commercial installation adds $2,000 to $10,000 per port for conduit, cable, and panel work. A single residential unit is simpler to wire at roughly $800 to $2,200, so a home EV charger installation cost lands around $1,100 to $2,700 all in before local taxes and incentives. Total commercial installed cost: $2,300 to $10,450 per port.
Klitv’s 7–22 kW AC charger suits home, apartment, and office installations as well as hotel, retail, and open-air public parking, with 7 kW, 11 kW, and 22 kW models on one platform. Our 60–80 kW DC fast chargers serve retail centers and commercial parking lots where faster turnaround matters.
DC Fast Charger Installation Cost (20–360 kW)
Hardware is only part of the cost. A 20 to 360 kW DC fast charger (DCFC) runs $5,200 to $9,500 factory-direct from China, with higher-power units at the top of the range. Installation, however, typically costs $40,000 to $120,000 per port in the 20–150 kW class as a mature-market benchmark. The main cost drivers are high-voltage service, trenching, utility interconnection, and specialized electrical labor. Grid-connection queues can stretch from several months to more than a year, depending on the network operator and market, which is why early planning is essential.
For high-traffic hubs and highway service areas, Klitv’s 120–240 kW DC charging stations deliver rapid charging with durable construction built for 24/7 operation.
High-Power Charging (150–360 kW)
At the top of the station range, 150 to 360 kW installations typically run $55,000 to $210,000 or more per port once hardware and infrastructure are combined. These projects often need a dedicated pad-mounted transformer ($20,000 to $80,000 or more), heavier switchgear, and longer utility timelines, although site-specific power architecture can reduce or remove some of these items. Site civil works scale up too: reinforced concrete pads, crash-rated bollards, and fire-safety clearances add another $5,000 to $15,000 per site. The charger hardware itself still stays within the $5,200 to $9,500 DC band.
For 360 kW and above, liquid-cooled hardware is the standard. Klitv’s 360–600 kW liquid-cooled supercharger platform covers highway corridor sites that expect heavy-duty, high-turnover traffic. Hardware cost per port peaks here; so does revenue per session. That’s why these sites often pencil out despite the steep entry price.
EV Charger Hardware Prices: What Is Included
When you import from China, the equipment quote sits apart from the installation quote. Two details decide whether the number you see is the number you pay: the price band for your power rating, and the cable length in the box.
- AC charger (7–22 kW): $300 to $450 per unit
- DC fast charger (20–360 kW): $5,200 to $9,500 per unit, with lower ratings near the bottom of the range and higher-power units near the top
- Charging cable: 5 m is the standard length in the Chinese market, and that length adds no extra charge
- OEM branding: standard printed logos on existing enclosures come at no charge; custom designs, colors, and firmware work are quoted separately
Cable length matters more than most buyers expect. Because 5 m is the domestic standard, ordering a station with a standard 5 m cable keeps you at list price. Longer or custom lengths are quoted separately and can extend lead time. A 5 m cable comfortably reaches the vehicle’s charge port from a well-placed pedestal in most parking layouts, so confirm the cable length on the quotation before you compare unit prices.
OEM work follows the same split. Printing your logo on a standard enclosure is usually free at the factory. Custom work is where fees appear: a new enclosure shape, brand colors, or a redesigned UI gets quoted line by line for engineering and tooling. Our OEM program lays out what each tier includes, and firmware/UI customization typically runs 7 to 14 days after specification sign-off.
A manufacturer’s ability to provide local installation or after-sales service also affects the charger price. Units backed by a localized service network are usually priced higher, but that premium can reduce future downtime, technician travel costs, and response delays.
These figures cover the charger and its standard cable only. They exclude shipping, import duties, local certification, and all site work. Treat them as the starting point of your budget, not the total.

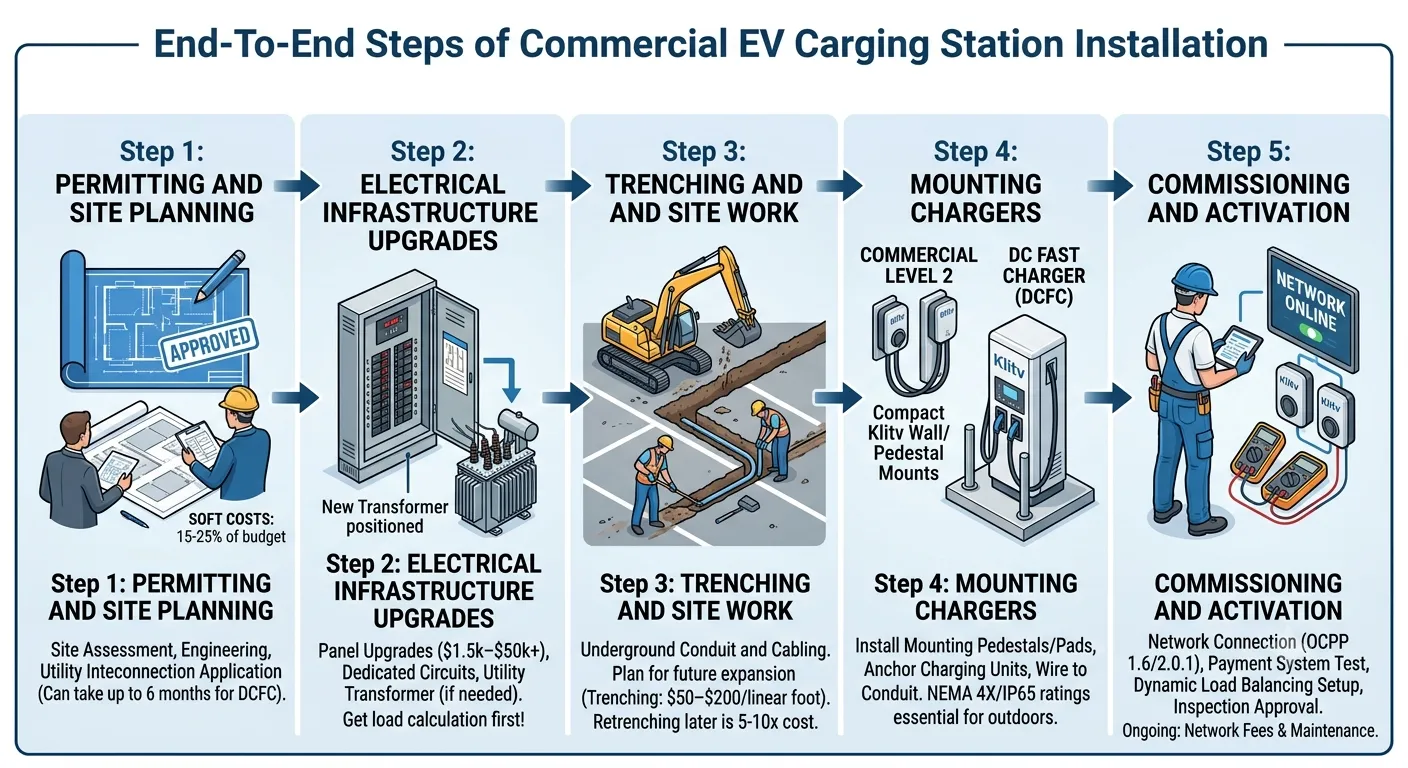

What Drives EV Charging Station Installation Costs
Five factors drive most EV charging installation budgets: distance from the electrical panel, existing panel and service capacity, site preparation and permits, charger hardware, and local labor rates. Panel and service upgrades are the biggest budget driver. Trenching alone can add $5,000 to $20,000 on a 100-foot run.
Distance from the Electrical Panel
More distance between the panel and the charger means more conduit, more cable, and more labor. As a benchmark, trenching costs $50 to $200 per linear foot (about $165 to $655 per metre), depending on terrain and whether you’re cutting through asphalt, concrete, or soft ground. A 100-foot run can add $5,000 to $20,000 to your project. Local excavation and reinstatement rates may differ sharply. Whenever possible, position chargers close to your electrical service.
Electrical Panel and Service Upgrades
This is the number one budget killer, and the most common surprise. A residential panel upgrade typically costs $1,500 to $3,000. For commercial sites with multiple DCFC ports, a service upgrade can cost $10,000 to $50,000 or more. Sites drawing over 200 kW may need a dedicated utility transformer, which adds both cost and months to your timeline.
Get a formal load calculation from a licensed electrician before you order any hardware. It’s the cheapest insurance against mid-project budget overruns.
Site Work and Trenching
Most commercial projects need underground conduit in parking lots. Rocky terrain, existing utilities, and paved surfaces all increase complexity and cost. Plan conduit runs during initial construction rather than retrofitting later. Retrofitting costs 5 to 10 times more than laying conduit at build time.
If you’re building a new parking lot or renovating, run oversized conduit now for future expansion. A 4-inch conduit costs marginally more than a 2-inch conduit at initial build, but re-trenching later costs a fortune.
Permitting, Inspections, and Accessibility Requirements
Permit fees, inspection requirements, engineering fees, and approval times are set locally. In many markets they form a meaningful share of first-time project budgets, and high-power DCFC usually faces deeper technical review than AC charging. Confirm which permits, grid-connection approvals, and electrical sign-offs apply before construction starts.
Accessibility requirements also differ by market. Charging spaces may need specific clearances, accessible routes, signage, surface markings, or protective bollards under local building and disability-access rules. Retrofit costs vary significantly, so include accessibility in the initial site plan and verify the requirements with the local authority.
Labor and Regional Rates
Electrician rates vary widely between and within countries. Mature infrastructure markets may charge $80 to $150 per hour or more, while rates in lower-cost markets can be much lower. The total can still rise where EV-specific expertise is scarce, because contractor mobilization, specialist support, rework, and delays add cost. Get a local itemized labor quote rather than applying another market’s rate.
Commercial EV Charging Station Installation: Full Cost Stack
Hardware is typically only 10 to 25 percent of a commercial EV charging project’s total cost. On high-power DC sites it can fall well under 10 percent, because infrastructure dominates. The full stack includes one-time capital items (charger units, electrical installation, trenching, permits, site preparation) plus recurring network fees, maintenance, electricity, and demand charges, the lines that decide your payback.
One-Time Capital Costs
- Charger units and mounting hardware
- Electrical installation and panel or service upgrades
- Trenching, conduit, and cabling
- Permits and inspection fees
- Accessible parking, bollards, and site preparation to local requirements
- Network commissioning and software setup
Ongoing Operating Costs
Sites that achieve 3-to-5-year payback periods are the ones that account for operating costs upfront, not just the installation invoice. For a commercial site, expect these recurring lines:
- Network and software fees: $100 to $400 per port per year for charging management software, payment processing, and support.
- Preventive maintenance: roughly 5% to 10% of hardware cost per year, covering cleaning, firmware updates, connector inspection, and component replacement.
- Electricity: your single largest recurring cost, set by local utility rates.
- Demand charges: utilities bill many DCFC sites a monthly demand charge based on peak power draw. A 150 kW charger can trigger thousands of dollars per year in demand charges alone. That’s why load management matters at high-power sites, and why some operators add battery storage to the mix (see below).

Battery Storage and Solar Add-Ons
Some sites add two more capital lines: battery storage and solar. Both attack the same cost items, demand charges and the electricity bill.
- Battery storage buffers peak draw so high-power chargers don’t trigger demand-charge spikes. Illustrative 2026 numbers: turnkey commercial LFP storage in the range of $400 to $600 per kWh installed, so a 500 kWh buffer adds roughly $200,000 to $300,000 to the project.
- Solar canopies offset grid electricity and give you covered parking in the same structure. Installed commercial PV runs in the range of $2.50 to $3.50 per watt, so a 250 kW canopy is roughly a $625,000 to $875,000 line.
Whether either one pays off depends on your local electricity rates and tariff structure, not on the charger itself. Klitv chargers integrate with third-party storage and PV through OCPP and load management, so the charging layer doesn’t lock you into any storage or solar vendor. Model the combined system before committing; a 500 kWh buffer only earns its keep where demand charges or peak tariffs are high.
For a deeper look at charger selection, read our commercial EV charger guide.
For revenue modeling, utilization assumptions, and payback analysis once the station is live, read our EV charger hub profitability guide.
How Hardware Quality Affects Your Total Cost
Buyers who choose EV chargers on price alone routinely pay more over the equipment’s lifetime. Cheaper units fail faster in commercial use. Each failure adds replacement, labor, and lost-revenue costs that the initial savings rarely cover. Commercial-grade construction, weather ratings, and documented quality control reduce that risk.
A logistics company in Thailand chose lower-cost chargers for their fleet depot. Within 18 months, four units had failed from corrosion caused by humidity and temperature cycling. Replacement costs, including labor and project downtime, came to $3,200 per failed unit. The original savings on hardware were erased, and then some.
Klitv chargers are built with a 2.0mm thickened steel body and high-precision components with no recycled materials. This matters in real-world conditions: outdoor installations, coastal humidity, temperature extremes, and 24/7 operation. Every charger is packed in industrial-grade wooden crates for safe global delivery.

When evaluating hardware, look beyond the purchase price. Ask about:
- Corrosion resistance ratings (look for NEMA 4X or IP65 minimum for outdoor use)
- Warranty length and what it actually covers (parts, labor, shipping)
- Mean time between failures (MTBF) data from the manufacturer
- Availability of replacement parts and local service support
For a detailed breakdown of what to look for, see our EV charger certifications and safety standards guide. If you plan to launch your own branded line, review our OEM and private-label manufacturing options.
How to Reduce EV Charging Station Installation Costs
You can cut EV charging installation costs with four moves: deploy multiple ports at once to share fixed costs, oversize conduit for future expansion, use load management to avoid service upgrades, and phase construction around available grid capacity. Klitv clients have saved thousands of dollars per port with these.
1. Deploy Multiple Ports Simultaneously
Sites deploying six or more charging ports at once achieve significantly lower per-port installation costs. Fixed costs like permitting, trenching, and utility upgrades are shared across all ports. A single-port 120 kW DCFC installation might cost $90,000. Six ports at the same site rarely cost $540,000. With shared trenching, a single service upgrade, and one permit, the total is typically closer to $300,000 to $400,000, or $50,000 to $65,000 per port.
2. Plan Conduit for a 5-Year Buildout
Installing a 4-inch conduit at initial build costs marginally more than a 2-inch conduit. If you need to add chargers later and the conduit is too small, you’ll re-trench at 5 to 10 times the original cost. Over-spec your conduit now and save the excavation later. Fleet operators get this right in our fleet charging depot design guide.
3. Use Load Management to Avoid Service Upgrades
Dynamic load balancing is one of the most underused cost-saving tools in commercial EV infrastructure. By intelligently distributing available power across multiple chargers, load management can avoid a $20,000 to $50,000 service upgrade entirely. Some sites running Klitv’s OCPP 1.6-compliant chargers with load management have avoided transformer upgrades that would have added 6 to 12 months to their timeline.
4. Source Certified Hardware from Established Manufacturers
The cheapest bid is rarely the cheapest outcome. Work with manufacturers who provide full certifications, a track record of deployments in your region, and local service support. For international buyers, read our guide on sourcing EV chargers from China.
How to Fund Your Project: Buy, Finance, or Charging-as-a-Service
Three funding paths dominate commercial EV charging in 2026: owner-funded purchase, equipment financing or leasing, and Charging-as-a-Service. Owner funding keeps 100% of revenue for high-traffic sites, financing spreads capital cost over three to seven years, and CaaS removes the upfront investment in exchange for a revenue share.
Owner-funded purchase. You pay the full cost upfront and keep 100% of charging revenue. This path suits high-traffic sites with confirmed utilization and access to eligible regional incentives.
Financing. Equipment loans and leases spread the capital cost over 3 to 7 years. Several lenders now specialize in EV infrastructure, and loan terms often align with the equipment’s useful life. Leases can bundle hardware, software, and maintenance into a single monthly payment.
Charging-as-a-Service (CaaS). A provider funds 100% of the equipment, installation, and ongoing operations in exchange for a share of charging revenue. You pay $0 upfront. This model is increasingly common for hotels, multifamily properties, and retail locations that want to offer EV charging without the capital outlay. The trade-off: you give up a portion of revenue and some control over pricing and user experience.
Incentive eligibility depends on project ownership and location, so compare the net capital cost of each funding path rather than the headline equipment price.
| Funding Path | Upfront Cost | Revenue | Control | Best For |
|---|---|---|---|---|
| Owner-funded purchase | 100% | You keep 100% | Full | High-traffic sites with confirmed utilization |
| Financing (loan/lease) | Deposit + monthly payments | You keep 100% minus debt service | High | Operators who want ownership with phased capital |
| Charging-as-a-Service | $0 | Shared with provider | Limited | Hotels, retail, multifamily with uncertain demand |
Not sure which model fits your project? Contact Klitv’s team to discuss your site specifics. We can help you evaluate all three paths.
Regional Incentives and Policy Support
There is no single global incentive framework for EV charging. Support can come from national, regional, or municipal governments, grid operators, utilities, development banks, or fleet programs. Eligibility often depends on where and when the project enters service, how the site is used, the equipment specification, and whether it meets open-access or interoperability requirements.
Common Forms of Support
- Capital grants and rebates: reduce upfront equipment or installation costs.
- Utility make-ready support: covers part or all of the upstream grid connection and service upgrade.
- Tax incentives: reduce the net capital cost through credits, accelerated depreciation, or exemptions.
- Tariff benefits: lower demand charges, provide off-peak pricing, or reduce grid-connection fees.
- Land and permitting support: offers public land, streamlined approval, or reduced municipal fees.
Program terms change frequently, and some schemes cannot be combined. Confirm current written rules with the administering agency or utility before relying on any incentive in the investment case.
Regional Examples to Verify
The following examples show how support differs; they are not an exhaustive list of eligible markets.
- United States: the federal Section 30C tax credit expired on June 30, 2026. NEVI funding and selected regional or utility programs remain available for qualifying projects, subject to current program rules.
- Europe: national and regional grant schemes, municipal support, and distribution-network make-ready or tariff programs vary by country and jurisdiction. Confirm the requirements that apply to the specific project location.
- Asia-Pacific, the Middle East, and Latin America: national EV plans, municipal land or permit benefits, utility programs, and tax measures may apply. Eligibility and funding levels vary widely between markets.
- China: provincial and municipal programs may support construction, grid connection, or operations. Check the latest requirements for the project’s province and city.
For a broader comparison, see our regional EV charger funding guide.
Localize the Landed Cost
For cross-border procurement, the factory price is only the first layer of the budget. Add freight, insurance, import duties, tax, local certification, customs clearance, warehousing, installation, and commissioning. Certification and grid-code requirements vary by market; do not assume a product approved in one region can be connected in another without additional assessment.
Klitv exports to 40+ countries across Southeast Asia, Europe, the Middle East, and Latin America. See our Germany Autobahn highway charging project for a European deployment example. Contact our team early in planning to confirm the certification, documentation, and service support applicable to your market.
Next Steps
Every commercial EV charging project starts with two things: understanding your site’s electrical capacity and knowing your target utilization. From there, you can model costs, evaluate hardware, and choose between owner-funded, financed, and service-based models.
If your site has high traffic and you have the capital budget, owner-funded deployment lets you capture 100% of revenue. If traffic is uncertain or capital is tight, compare Charging-as-a-Service providers. The hybrid model, partial self-funding with a service partner, works well for mixed-use properties with moderate utilization.
Whatever path you choose, plan around utility timelines. DCFC projects can take 9 to 18 months from planning to commissioning, depending on the market and grid operator. The most reliable ways to reduce your EV charging station installation cost are disciplined site planning, load management to avoid upgrades, multi-port deployment to share fixed costs, certified hardware that won’t fail early, and a locally validated service plan.
